Old Lake Wilson Road Widening

Share Old Lake Wilson Road Widening on Facebook Share Old Lake Wilson Road Widening on X (formerly Twitter) Share Old Lake Wilson Road Widening on Linkedin Email Old Lake Wilson Road Widening link


The project includes the widening of Old Lake Wilson Road from a 2-lane roadway to a 4-lane divided facility from CR 532 to Sinclair Road, a distance of approximately 2.5 miles. Osceola County will improve the segment from CR 532 to Assembly Court while FDOT will improve the segment from Assembly Court to Sinclair Road, including the bridge over Interstate 4, as part of FDOT's Moving Florida Forward improvements. For more information regarding FDOT's plans for Old Lake Wilson Road, please visit: https://i4beyond.com/ and https://movingi4forward.com/, Project 2.

Both the County and FDOT segments will include the addition of bicycle and pedestrian features along the corridor.

Osceola County’s segment will also include:

  • Addition of a traffic signal at Spine Road
  • Upgrade of existing culvert to bridge at Davenport Creek
  • Improvements to drainage systems and stormwater ponds
  • Upgrades to the Intelligent Transportation System (ITS)
  • Addition of street lighting
  • Landscape considerations

For additional information on improvements planned by the Central Florida Expressway Authority to SR 532 (Osceola-Polk Line Road), please visit: https://www.cfxway.com/for-travelers/projects/county-road-532-osceola-polk-line-road-capacity-improvements/


Project Schedule








The project includes the widening of Old Lake Wilson Road from a 2-lane roadway to a 4-lane divided facility from CR 532 to Sinclair Road, a distance of approximately 2.5 miles. Osceola County will improve the segment from CR 532 to Assembly Court while FDOT will improve the segment from Assembly Court to Sinclair Road, including the bridge over Interstate 4, as part of FDOT's Moving Florida Forward improvements. For more information regarding FDOT's plans for Old Lake Wilson Road, please visit: https://i4beyond.com/ and https://movingi4forward.com/, Project 2.

Both the County and FDOT segments will include the addition of bicycle and pedestrian features along the corridor.

Osceola County’s segment will also include:

  • Addition of a traffic signal at Spine Road
  • Upgrade of existing culvert to bridge at Davenport Creek
  • Improvements to drainage systems and stormwater ponds
  • Upgrades to the Intelligent Transportation System (ITS)
  • Addition of street lighting
  • Landscape considerations

For additional information on improvements planned by the Central Florida Expressway Authority to SR 532 (Osceola-Polk Line Road), please visit: https://www.cfxway.com/for-travelers/projects/county-road-532-osceola-polk-line-road-capacity-improvements/

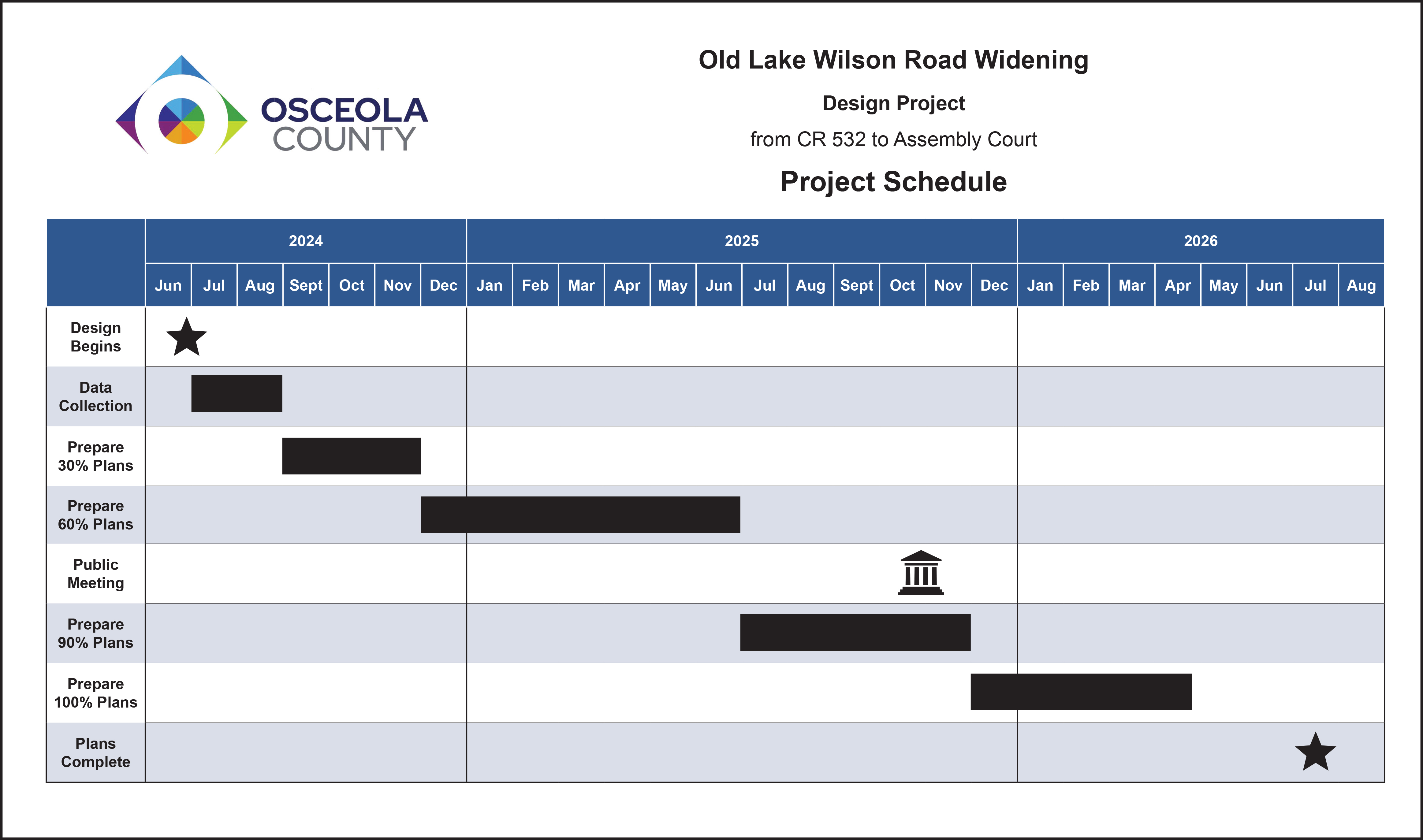

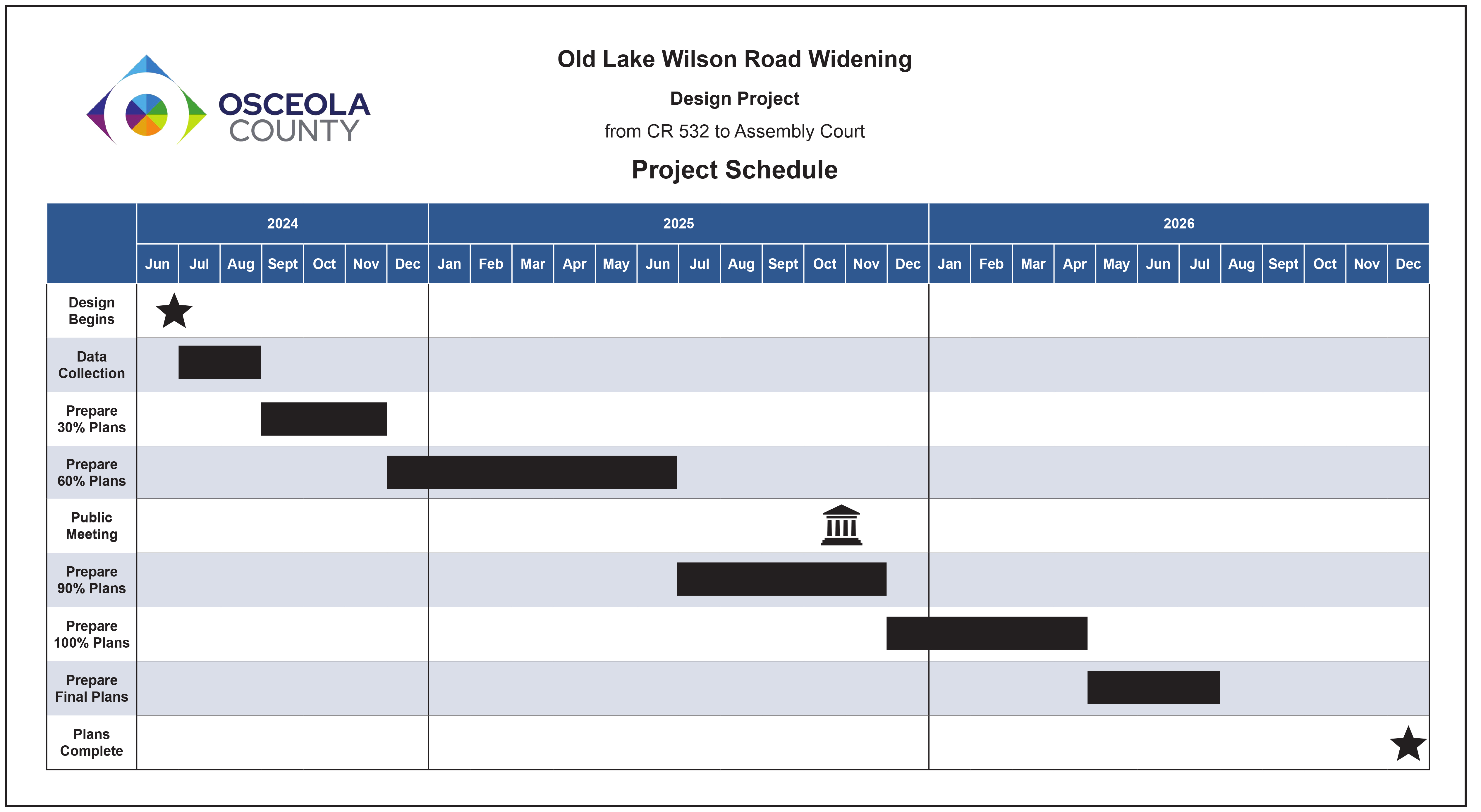

Project Schedule
